This article discusses the technical side of how Project schedules the tasks in your Project. People are sometimes confused when Project automatically moves a task to a different time than they expected. Or they wonder why changing, say, a task constraint caused other tasks to move unpredictably. Here’s your chance to understand the big “Why?” behind Project’s powerful scheduling engine.
This isn’t necessarily easy to understand at first, but going through it will make you a more knowledgeable project manager—and give you firmer control over the end date of your project.
What do you want to learn?
- How does the project start date affect the schedule?
- How do task links affect the schedule?
- How do constraints on tasks affect the schedule?
- How do task types affect the schedule?
- How does effort-driven scheduling affect the schedule?
- How do manual and automatic scheduling affect the schedule?
- How does float (or slack) affect the schedule?
- How do deadline dates affect the schedule?
- How do calendars affect the schedule?
- How do resource assignments drive the schedule?
- Get more technical information about how Project schedules
How does the project start date affect the schedule?
When you add a new task to a schedule, it automatically is scheduled to start on the project’s start date. As tasks are added to the schedule and connected to other tasks, the start times of tasks will change, and the last task to finish determines the project’s finish date.
- To find the Project start date or to change it to another date, select Project, and then select Project Information.
Of course, there are going to be exceptions. For example, tasks don’t move around as other tasks move. Read below in this article to learn more about manually versus automatically scheduled task scheduling.
When you create a new project, you first enter the project's start date. When you schedule a project from the start time, all tasks start at the project start date unless you specify otherwise.
For both manually scheduled tasks and automatically scheduled tasks, with no task dependencies or constraints applied, the project's duration is the same as the duration of the longest task. In other words, the project finish date is the same as the longest task's finish date.
Task dependencies, such as the finish-to-start dependency between the first and second tasks (as shown here), can change the project's finish date.
Nearly all projects should be scheduled from a known start time. Even if you know the date that a project must be completed on, scheduling from a start date gives you maximum flexibility.
However, you might want to schedule from a finish date when:
- You need to determine when a project must start so that it finishes on a specific required date.
- You aren't sure when your project will begin (for example, you are receiving work from another source that could be delayed).
- Your project management methodology requires you to schedule from a finish date.
As you work with your project that's scheduled from a finish date, be aware of differences in the way that Project handles some actions:
- When you enter an automatically scheduled task, Project automatically assigns the As Late As Possible (ALAP) constraint to the finish date of the task. You should set other constraints only when necessary (Select a task, and then select Task > Information).
- If you drag a Gantt bar to change the finish date of a task, Project automatically assigns a Finish No Later Than (FNLT) constraint for an automatically scheduled task.
- If you change your project to schedule from a finish date and it was previously scheduled from a start date, you will remove all leveling delays and leveling splits from tasks and assignments that have been automatically scheduled. Tasks that are manually scheduled aren't affected.
- If you use automatic leveling to reduce resource overallocations in your project, Project will add a leveling delay after a task rather than before a task (To check leveling settings, select the Resource tab, and then select Level Resource.).
How do task links affect the schedule?
Task links (dependencies) show the relationship in time of one task to another. Linking tasks creates task dependencies. The long chain of tasks determines the entire length and end of a project.
Project management tip As you link tasks in a project, a critical path of links is set up. This critical path determines the end of your project. Learn more about the critical path.
| Link type | Example | Description |
|---|---|---|
| Finish-to-start (FS) |
|
The dependent task (B) cannot begin until the task that it depends on (A) is complete. For example, if you have two tasks, "Dig foundation" and "Pour concrete," the "Pour concrete" task cannot begin until the "Dig foundation" task is completed. When you link tasks in Project, the default link type is finish-to-start. If you don’t specify a link type, the Finish-to-start relationship is assumed. |
| Start-to-start (SS) |
|
The dependent task (B) can't begin until the task that it depends on (A) begins. The dependent task can start at any time after the task that it depends on begins. The SS link type doesn't require that both tasks begin at the same time. For example, if you have two tasks, "Pour concrete" and "Level concrete," the "Level concrete" task can't begin until the "Pour concrete" task begins. |
| Finish-to-finish (FF) |
|
The dependent task (B) can't be completed until the task that it depends on (A) is completed. The dependent task can be completed at any time after the task that it depends on is completed. The FF link type doesn't require that both tasks be completed at the same time. For example, if you have two tasks, "Add wiring" and "add plumbing," both must be completed at the same time before any inspection can be done. |
| Start-to-finish (SF) |
|
The dependent task (B) can't be completed until the task that it depends on (A) begins. The dependent task can be completed at any time after the task that it depends on begins. The SF link type doesn't require that the dependent task be completed concurrent with the beginning of the task on which it depends. This link type is rarely used in project management. An example would be roofing a home, and the two tasks: add roofing, supervise the work. In this case, the roofing can start, but the supervisor needs to show up at some point before the end of the roofing. |
Note about manuallyscheduled tasks: When you link a manually scheduled task to another task, Project respects the link type and places the manually scheduled task relative to the other task. For example, the successor task with an FS link is shown as beginning when the predecessor finishes. However, the successor task will only move when the link is created. If the predecessor later changes its finish date, the successor’s start date will remain unchanged.
However, you can configure Project such that a manually scheduled task doesn't move when it's linked to another task.
- Select File > Options > Schedule.
- Uncheck the Update manually scheduled tasks when editing links checkbox.
How do constraints on tasks affect the schedule?
Constraints allow you to control the start or finish date of an automatically scheduled task. There are three types of constraints:
- Flexible constraints: These constraints don't have specific dates associated with them. Setting these constraints allows you to start tasks as early as possible or as late as possible, with the task ending before the project finish, given other constraints and task dependencies in the schedule.
- Semi-flexible constraints: These constraints require an associated date that controls the earliest or latest start or finish date for a task. These constraints allow a task to finish at any time, as long as it meets the start or finish deadline.
- Inflexible constraints: These constraints require an associated date that controls the start or finish date of the task. These constraints are useful when you need to make your schedule take into account external factors, such as the availability of equipment or resources, deadlines, contract milestones, and start and finish dates.
Project management tip In nearly all cases, use the As Soon As Possible (ASAP) constraint. This gives the scheduling engine maximum flexibility in determining the ideal finish date for your project.
Here are two ways to instantly view the constraints on your tasks.
- To review or change a constraint, select a task, and then select Task > Information. Select the Advanced tab to see the Constraint type and Constraint date boxes.
- If the constraint is anything other than ASAP or ALAP, the constraint type will display its associated graphical indicator in the Indicator column in any sheet view, such as the Gantt chart.
Constraints with moderate scheduling flexibility will restrict a task from starting or finishing before or after a date you choose. For example, a task with a Start No Earlier Than (SNET) constraint for June 15 and an FS dependency to another task can begin June 15 if its predecessor is finished by June 15 (or later if its predecessor finishes after June 15), but it can't be scheduled before June 15. For example, this might be an appropriate use of constraints if you have a building permit that's only good for specific dates. In this case, the SNET or FNLT constraints might be used.
With the default finish-to-start task relationship and an ASAP constraint applied to these tasks, the successor task (the second one) is scheduled to begin as soon as the predecessor task (the first one) is scheduled to finish.
With a SNET constraint applied, the successor task cannot begin before the constraint date, even if (as shown here) the predecessor task is completed before the constraint date.
The following table lists the constraints provided in Project.
| Constraint type | Constraint name | Description |
|---|---|---|
| Flexible | As Late As Possible (ALAP) | Schedules the task as late as possible with the task ending before the project ends and without delaying subsequent tasks. This is the default constraint for tasks when you schedule from the project finish date. Do not enter a task start or finish date with this constraint. |
| Flexible | As Soon As Possible (ASAP) | Schedules the task to begin as early as possible. This is the default constraint for tasks when you schedule from the project start date. Don't enter a start or finish date with this constraint. |
| Semi-Flexible | Start No Earlier Than (SNET) | Schedules the task to start on or after a specified date. Use this constraint to ensure that a task doesn't start before a specified date. |
| Semi-Flexible | Finish No Earlier Than (FNET) | Schedules the task to finish on or after a specified date. Use this constraint to ensure that a task doesn't finish before a certain date. |
| Semi-Flexible | Start No Later Than (SNLT) | Schedules the task to start on or before a specified date. Use this constraint to ensure that a task doesn't start after a specified date. |
| Semi-Flexible | Finish No Later Than (FNLT) | Schedules the task to finish on or before a specified date. Use this constraint to ensure that a task doesn't finish after a certain date. |
| Inflexible | Must Finish On (MFO) | Schedules the task to finish on a specified date. Sets the early, scheduled, and late finish dates to the date that you type and anchors the task in the schedule. |
| Inflexible | Must Start On (MSO) | Schedules the task to start on a specified date. Sets the early, scheduled, and late start dates to the date that you type and anchors the task in the schedule. |
By default, all tasks in a project that's scheduled from the start date have the ASAP constraint applied. Likewise, by default, all tasks in a project that's scheduled from the finish date have the ALAP constraint applied.
Inflexible constraints usually override any task dependencies and restrict a task to a date you choose. For example, a task with an MSO constraint for September 30 and an FS dependency to another task will always be scheduled for September 30 no matter whether its predecessor finishes early or late. You can change this behavior. Select File > Options > Schedule and then select the Tasks will always honor their constraint dates checkbox.
How do task types affect the schedule?
Task types apply only to automatically scheduled tasks; they come in three flavors: fixed units, fixed work, and fixed duration. Project looks at a task’s type to determine how duration, work, and units will behave as Project schedules your project.
Each of the task types affects scheduling when you edit one of the three elements, as described in the following table:
| In a | If you revise units | If you revise duration | If you revise work |
|---|---|---|---|
| Fixed units task | Duration is recalculated. | Work is recalculated. | Duration is recalculated. |
| Fixed work task | Duration is recalculated. | Units are recalculated. | Duration is recalculated. |
| Fixed duration task | Work is recalculated. | Work is recalculated. | Units are recalculated. |
- To change a task type, select the task, select Task > Information and go to the Advanced tab.
Some examples
Let's say you have a fixed-units task, with 1 full-time resource unit available for 8 hours each day. You set up the task with a 10-day duration and 80 hours of work.
- If you find out that another full-time resource can assist on the task, Project recalculates the task's duration. The task now has two units assigned with a 5-day duration and 80 hours of work.
- If you find out that you have 8 days to complete the task rather than 10, Project recalculates the task's work. The task now has an 8-day duration with 64 hours of work and 1 resource unit.
- If you find out that the task will take 20 hours of additional work, Project recalculates the task's duration. The task now has 100 hours of work with a duration of 12.5 days and 1 resource unit.
Now let's say you make the same task a fixed-work task. This means that the task can take only the amount of work that you specify: no more, no less. In this example, the task has 1 full-time resource available for 8 hours each day, and it has a 10-day duration with 80 hours of work.
- If you find out that another full-time resource can assist on the task, Project recalculates the task's duration. The task now has 2 units assigned, with a 5-day duration and 80 hours of work.
- If you find out that you have 8 days to complete the task rather than 10, Project recalculates the task's resource units. In order to get the task done in 80 hours over 8 days, 1.25 resource units must be assigned. The resource unit that is currently assigned to the task is allocated at 125%. You need to assign another resource to account for the additional 25% allocation.
- If you find out that the task will take 20 hours of additional work, Project recalculates the task's duration. The task now has 100 hours of work with a duration of 12.5 days and 1 resource unit.
Finally, let's say you make the same task a fixed-duration task. This means that the task must be completed in the duration that you specify. Again, in this example, the task has 1 full-time resource available for 8 hours each day, and it has a 10-day duration with 80 hours of work.
- If you find out that another resource can assist on the task, Project recalculates the work assigned to each resource. When just 1 resource was assigned to the task, that resource had 80 hours of work to complete. When you assign another resource to the task, each resource has 40 hours of work to complete over the same 10-day duration, for a total of 80 hours of work. By adding another resource unit, you also revise the allocation of both units to 50% each, making them both available to work 50% on other tasks.
- If you find out that you have 8 days to complete the task rather than 10, Project recalculates the task's work. The task now has an 8-day duration with 64 hours of work and 1 resource unit.
If you find out that the task will take 20 hours of additional work, Project recalculates the task's resource units so that the additional work can still be completed within the 10-day duration. The task now has 100 hours of work, with a duration of 10 days and 1.25 resource units. The resource unit that's currently assigned to the task is allocated at 125%. You need to assign another resource to account for the additional 25% allocation.
Note
Because assignments of cost resources don't have values for work or units, these values won't be recalculated when the task's start date or finish date is modified. Dates also are never recalculated for a cost resource assignment because you cannot modify the work or units.
Here’s a table of things to keep in mind about task types.
| Tips and Gotchas | Explanation |
|---|---|
| Look out for effort-driven tasks | If you select Fixed Work in the Task type list, you can't change the Effort driven setting for the task. Fixed work tasks don't have flexible work values and are therefore always effort driven. Learn more about effort-driven tasks. |
| Add a column to help you change task type | You can view and change the task type for each task directly in your view by inserting the Type field. Select the column to the right of where you want to insert the new column, select the Insert menu, and then select Column. In the Field name list, select Type. |
| Summary tasks are always fixed-duration tasks | Summary tasks are always fixed-duration types because a summary task’s start and finish dates are determined by its subtasks. |
| Use indenting to outline, not task types | If you want to change the hierarchical structure of a task or subtask as part of an outline structure for your project, you need to indent or outdent the task rather than change the task type or add a deadline date. |
| Don’t’ confuse task constraints, like ASAP, with task types | If you want to impose restrictions on the way Project calculates the start and finish dates of tasks, you need to set a task constraint, rather than the task type. |
How does effort-driven scheduling affect the schedule?
For all tasks, after you assign a resource, the task is scheduled according to this formula (assuming tasks are the default fixed-units task type):
Duration = Work / Units
- For any task, you can choose which piece of the equation Project calculates by setting the task type. When you assign or remove people from a task, Project lengthens or shortens the duration of the task based on the number of resources that are assigned to it, but Project does not change the total work for the task. This is called effort-driven scheduling. This setting is usually turned off. To turn it on, select File > Options > Schedule and select the New tasks are effort driven checkbox.
Although effort-driven scheduling can work in most scenarios, you may want to change this behavior to more accurately reflect what happens on a particular task when resources are added or removed. For example, you may want to see the total work increase as you add more people to a particular task.
- Select a task, select Task > Information, and then select the Advanced tab.
- Uncheck the Effort driven checkbox.
Note
You can't remove effort-driven scheduling from Fixed work tasks. Fixed work tasks don't have flexible work values and are therefore always effort driven.
When you work with effort-driven scheduling, keep the following in mind:
| Tips and Gotchas | Explanation |
|---|---|
| Effort driven doesn't apply to the first resource assigned | The effort-driven calculations apply only after the first resources are initially assigned to the task. After the first resources are assigned, the work value doesn't change as new resources are assigned to or removed from the same task. |
| Be aware of Fixed-unit tasks | If the assigned task type is Fixed Units, assigning additional resources shortens the duration of the task. |
| Be aware of Fixed-duration tasks | If the assigned task type is Fixed Duration, assigning additional resources decreases the individual unit values for resources. |
| Be aware of Fixed-unit tasks | If the assigned task type is Fixed Work, assigning additional resources shortens the duration of the task. |
| Some tasks can be set to effort driven | Summary tasks and inserted projects can't be set to Effort driven. |
How do manual and automatic scheduling affect the schedule?
Knowing the differences between manually scheduled tasks and automatically scheduled tasks is key to understanding how Project schedules your project.
Generally, manually scheduled tasks put you in control of the schedule. When you add a task to your schedule, it stays put. However, this isn’t always the best way to design a schedule, especially as projects get more complicated, where you might want to use automatically scheduled tasks to take advantage of Project’s powerful scheduling engine.

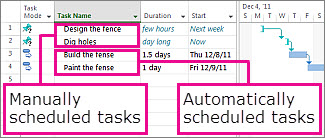

Take a look at the picture below. It shows the two different types of tasks, the first two manually scheduled, and the last two automatic.
For the manually scheduled tasks, the duration is a text value and a number. Since the duration can be a text value, a start date hasn't been set automatically by Project, and the Gantt bar is only partially displayed to reflect the uncertainty of the task schedule at this point.
For the automatically scheduled task, the duration is a number value with a time unit appended, such as “12h” for twelve hours duration. By definition, automatically scheduled tasks with valid durations, start dates, and finish dates—and therefore, bars—are automatically drawn by Project.
Now, it gets a little tricky sometimes with the information you provide for manually scheduled tasks. All that's needed for Project to draw bars on a manually scheduled task are three values: duration, start date, and finish date. If you set two of these values for a manually scheduled task, the third value will be calculated by Project automatically, and the task will remain manually scheduled. So, look out for this kind of “unexpected” behavior from Project.
Note
Tasks are manually scheduled by default. Project managers who are accustomed to automatic scheduling with past versions of Project can turn off the manual scheduling feature for specific tasks or for the entire project. Some projects, especially complicated ones, may require Project's powerful scheduling engine to take care of scheduling for you. To change all tasks to be automatically scheduled, select New Tasks: Automatically Schedule at the bottom of the Project application window.
Manually scheduled tasks
You can place a manually scheduled task anywhere in your schedule, and Project won't move it. This new feature gives you greater flexibility and control over planning and managing the schedule.
Why would you care? Well, at times, project schedules are often very informal. They begin as simple lists of dates from emails, meeting with stakeholders, or a hallway conversation. Project managers very often don't have complete information on work items. For example, they may only be aware of when a task needs to be started, but not its duration until they have an estimate from their team members. Also, they may know how long a task will take, but they don't know it can't be started until they have approval from the resource manager.
Here are some things to keep in mind with manually scheduled tasks.
- You'll never be left in the dark: Manually scheduled tasks have their own indicators and task bars to help you distinguish them from the "classic" automatically scheduled tasks.
- Anything goes: When a task is in manually scheduled mode, the Start, Finish, and Duration columns can be blank or include text values in addition to recognizable dates.
- Switching scheduling modes: You can change a task back and forth from manually scheduled to automatically scheduled. Be careful, though. When you change a task from manually scheduled to automatically scheduled, Project is going to have to make some decisions. If a task's duration was "A fortnight," Project usually sets an estimated duration of "1 day?" if the task is set to automatically scheduled. After all, you can’t expect project to know that a fortnight is two weeks long.
- Control slippage: If a manually scheduled task has to be delayed due to a slippage, its successor tasks won't be automatically pushed out. Project managers can decide to keep the original dates if their resources are able to proceed as planned or delay the successor tasks if there are hard dependencies.
- Effort-driven impacts: Manually scheduled tasks cannot be set to effort driven. The duration of a manually scheduled task won't change as more resources are assigned to it or removed from it. Learn more later in this article.
The following table shows how Project attributes are defined and used for scheduling manually and automatically scheduled tasks.
| Item | Manually scheduled | Automatically scheduled |
|---|---|---|
| Duration | Can be number, date, or text information, such as "14d" or "fortnight." Not used by Project to help schedule the project if value isn't in a recognizable format for duration. | Only numbers representing time length and units can be used, such as "14d" or "2 months." |
| Work | Only numbers representing time length and units can be used, such as "14d" or "2 months." | Only numbers representing time length and units can be used, such as "14d" or "2 months." |
| Resources | Can be assigned to tasks. Resource calendars aren’t used by Project to help schedule tasks. | Can be assigned to tasks. Used by Project to help determine best schedule. Will change the duration of tasks if tasks are set to effort driven, unlike manually scheduled tasks. |
| Start date | Can be a number, date or text information, such as "Jan 30" or "Sometime soon." Not used by Project to Help schedule the project if value is not in a recognizable format for time. | Only date information can be used. However, you can use values “today” and “tomorrow,” which Project reserves for automatically scheduled tasks. |
| Finish date | Can be a date or text information, such as "Jan 30" or "Sometime soon." Not used by Project to help schedule the project. | Only date information can be used. However, you can use values “today” and “tomorrow,” which Project reserves for automatically scheduled tasks. |
| Constraints | Ignored by Project. | Used by Project to help determine best schedule. |
| Dependencies (links) | Can be used but won't change the scheduling of the task. However, task links will reschedule a task when first applied. | Can be used and will change scheduling of the task. |
| Project and resource calendars | Ignored by Project. | Used by Project to help determine best schedule. |
Automatically scheduled tasks
Automatically scheduled tasks are the classic way Project schedules your tasks. Automatic scheduling provides a highly structured, systematic means of managing project schedules. Based on users’ input, such as task duration, planned work, number of resources, and constraint dates, Project calculates the earliest and latest dates for tasks for the optimal schedule.
Project schedules a project from the information that you enter about the following:
- The overall project.
- The individual work items (called tasks) required to complete the project.
- If necessary, the resources needed to complete those tasks.
If anything about your project changes after you create your schedule, you can update the tasks or resources and Project adjusts the schedule for you.
For each task, you might enter one or all of the following:
- Durations
- Task dependencies
- Constraints
Using this information, Project calculates the start date and finish date for each task.
You can enter resources in your project and then assign them to tasks to indicate which resource is responsible for completing each assignment. Not only does this help you plan project staffing, it can also help you to calculate the number of machines needed or the quantity of material to be consumed. If you enter resources, task schedules are further refined according to the following resource information:
- Work
- Units
- Working times and nonworking times entered in calendars
Other elements, such as lead time and lag time for links, task types, resource availability, and the driving resource, can affect scheduling; so, understanding the effects of these elements can help you to maintain and adjust your schedule as needed.
Note
Project calculates the duration of automatically scheduled tasks based on the definitions of the duration units (Select File > Options > Schedule). Just like a normal monthly calendar, the year begins in January and each week begins on Sunday or Monday. By default, when Project calculates duration units, one day equals 8 hours, one week equals 40 hours, and one month equals 20 working days. If you enter start and finish dates for tasks and don't enter start and finish times, Project uses 8:00 A.M. as the default start time and 5:00 P.M. as the default end time.
Changing task scheduling modes
You can change a task's scheduling back and forth from automatic to manual (Select File > Options > Schedule). When you change task modes, keep the following in mind:
- A task that's changed to automatic scheduling will have duration and dates set to Project's default settings. For example, Project will change a manually scheduled task with a duration of "A couple weeks" to the default of "1 day?" A task with a manually entered start date of "tomorrow," will have the start changed to the project start date when it's changed to an automatically scheduled task.
- A task that's changed to manually scheduled will retain its duration and dates. However, after the task is set to manually scheduled, the duration and dates can be any number, text, or date value.
How does float (or slack) affect the schedule?
Float (also known as slack) helps you find those tasks that can budge without changing the end date of your project. You may want to view tasks that can currently slip without affecting the critical path (total slack) or those tasks that can slip before affecting the task that they are connected to (free slack).
Here are two ways to view float in your schedule.
- While in the Gantt chart, select Gantt Chart Format, then select the Slack checkbox. Float appears as a thin line attached to the end or beginning of Gantt bars.
- Use the Detail Gantt view. Select View > More Views, and then choose Detail Gantt. Select Apply. Now, back in the Gantt chart, select Tables > Schedule.
Here a couple things to keep in mind about float:
| Tips and gotchas | Explanation |
|---|---|
| Watch out for inflexible constraints | If a task that's constrained to a date has a predecessor that finishes too late for the successor to begin on the date specified in the constraint, negative slack can occur. Negative slack will even further constrain the end date of your project. |
| Deadline dates changes total slack | Deadline dates can affect the total slack on tasks. If you enter a deadline date before the end of the task's total slack, total slack will be recalculated by using the deadline date rather than the task's late finish date. The task becomes critical if the total slack reaches zero. |
How do deadline dates affect the schedule?
Deadline dates don't usually affect task scheduling. They are used to indicate a target date you don't want to miss, without requiring you to set a task constraint that could affect scheduling if predecessor tasks change. A task with a deadline is scheduled just like any other task, but when a task finishes after its deadline, Project displays a task indicator notifying you that the task missed its deadline.
To review or change a task deadline, select the task and select Task > Information. On the Advanced tab, use the Deadline box.
Deadline dates can affect the total slack on tasks. If you enter a deadline date before the end of the task's total slack, total slack will be recalculated by using the deadline date rather than the task's late finish date. The task becomes critical if the total slack reaches zero.
You can set deadlines for summary tasks and individual tasks. If the summary task's deadline conflicts with any of the subtasks, the deadline indicator signifies a missed deadline among the subtasks.
But deadline dates can affect how tasks are scheduled if you set a deadline date on a task with an ALAP constraint. The task is scheduled to finish on the deadline date, though the task could still finish after its deadline if its predecessors slipped.
How do calendars affect the schedule?
Calendars determine the standard working time and nonworking time, such as weekends and holidays, for the project.
Note
The dates of manually scheduled tasks (if entered) won't change based upon changes to the project or resource calendars.
Project calendars are used to determine the resource availability, how resources that are assigned to tasks are scheduled, and how the tasks themselves are scheduled. Project and task calendars are used in scheduling the tasks, and if resources are assigned to tasks, resource calendars are used as well.
Calendars override each other’s settings in the following ways:
- When you create a task, the project calendar schedules the task.
- When you add a resource to a task, the resource calendar controls the scheduling of the task.
- When you add a task calendar to a task and set the calendar setting to Scheduling ignores resource calendars in the Task Information box, the task calendar controls the scheduling and will ignore the schedule of any resources assigned to the task.
To work with calendars, select Project, then select Change Working Time.
| Calendar type | Description |
|---|---|
| Base calendars | These are the foundations for the other types of calendars. You can also choose a base calendar to be the project calendar, and you can apply a base calendar to tasks as a task calendar or as the default hours for a resource calendar. You can customize your own base calendar by using any of the base calendars provided. Project provides three base calendars: The Standard calendar The Standard calendar is the default calendar for the project and is the basis for resource calendars. This calendar reflects a traditional work schedule: Monday through Friday, 8:00 A.M. to 5:00 P.M., with an hour off for break. 24-Hours calendar The 24-Hours calendar reflects a schedule with no nonworking time at all. The 24-Hours calendar can be used when resources and tasks are scheduled for different shifts around the clock, or when equipment resources work on tasks continuously. Night Shift calendars The Night Shift calendar reflects a graveyard shift schedule of Monday night through Saturday morning, 11:00 P.M. to 8:00 A.M., with an hour off for break. |
| Project calendars | These set the standard working and nonworking times for the project as a whole. If resource calendars or task calendars aren't used, tasks are scheduled during the working time on the project calendar by default. |
| Resource calendars | These are usually based on the Project calendar at the time of resource creation. You can change working time or nonworking time for specific resources or a set of resources, ensuring that resources are scheduled only when they are available for work. If you have changed working or nonworking time on a resource calendar and the resource is assigned to a task, the task is scheduled during the working time on the resource calendar. This may also affect the finish date of the task. Resources can either inherit the nonworking time from the base calendar or override this time with nonworking time settings on the resource calendar. |
| Task calendars | These can be used to define working times for tasks outside the working times in the project calendar. Task calendars are created like other calendars. When a task calendar is assigned to a task and the resource assigned to the task has different working times in its resource calendar, the task is scheduled for the overlapping working time of the two calendars. But you can set a task option to ignore resource calendars and schedule the task through the resource's nonworking time. If no task calendar is specified for a task, the Project calendar will be used to schedule the task. |
How do resource assignments drive the schedule?
If you don't assign resources to tasks in your project, Project calculates the schedule using durations, task dependencies, constraints, and project and task calendar information. If you do assign resources, the tasks are also scheduled according to resources' calendars and assignment units, providing for more accurate scheduling.
Note
Manually scheduled tasks aren't affected by resource calendars. When a resource is assigned to a manually scheduled task, the scheduling of the task won't change.
An assignment is the association of a specific task with a specific resource that's responsible for completing the task. More than one resource can be assigned to a task. Work resources, material resources, and cost resources can be assigned to tasks. Unlike work resources, assigning material resources or cost resources to a task doesn't affect task scheduling.
For example, in your project you have a task named Develop specifications. You also have an engineering resource, Sean. If you assign Sean to the Develop specifications task, the scheduling of this task depends on Sean's resource calendar and assignment units, in addition to task information such as duration, task dependencies, constraints, and calendars.
In addition to scheduling according to task information, after you assign resources to the tasks in your project, Project has additional resource and assignment information to use in calculating schedule information, including:
| Resource attribute or setting | Explanation |
|---|---|
| Work | The amount of work or overtime work the resource is assigned to do, and how that work is distributed over time. Work distribution over time can also be affected by work contours. |
| Assignment units | The number of assignment units for the resource, that is, part-time, full-time, or multiple, on the task. |
| Task type | The task type, which affects how a schedule changes if you revise the existing assignment. The three task types are fixed unit, fixed duration, and fixed work. |
| Effort driven | If a task is effort driven, as resources are added or removed on the assignment, the work remains constant for the task and is redistributed among the resources. For fixed-unit tasks, for example, one result is that if more resources are assigned, a shorter duration is required to complete the task. Learn more about the effort-driven setting. |
| Calendars | Resource calendars. Project schedules the assigned resources based on the working and nonworking times indicated on their resource calendars. |
| Work contours | Work contours allow you to fine-tune when resources are working on tasks, such as during a ramp-up phase. In the Task Usage view, right-click the name of the resource assigned to a task, then select a predefined work pattern in the Work contour list. After selecting the pattern, you can manually tweak the hours in the time-phased portion of the usage view. |
To assign resources to tasks, select the Resource tab, and then select Assign Resources.
